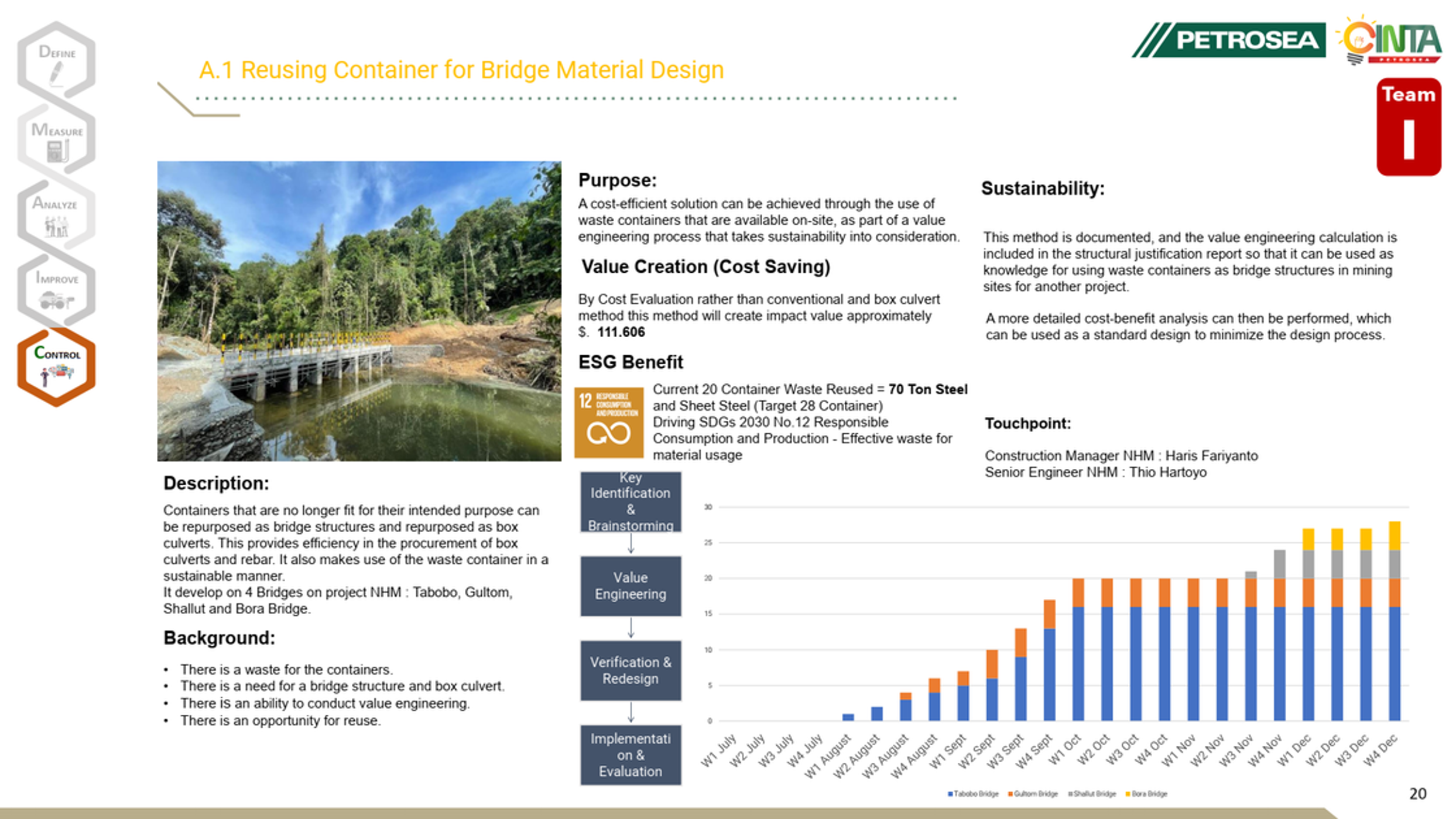

Repurposed shipping containers and sheet steel as structural bridge elements across four NHM bridges.

Remote projects needed 60-ton access bridges under tight deadlines amid rising costs and ESG mandates.
Repurposed shipping containers and sheet steel as structural bridge elements across four NHM bridges.

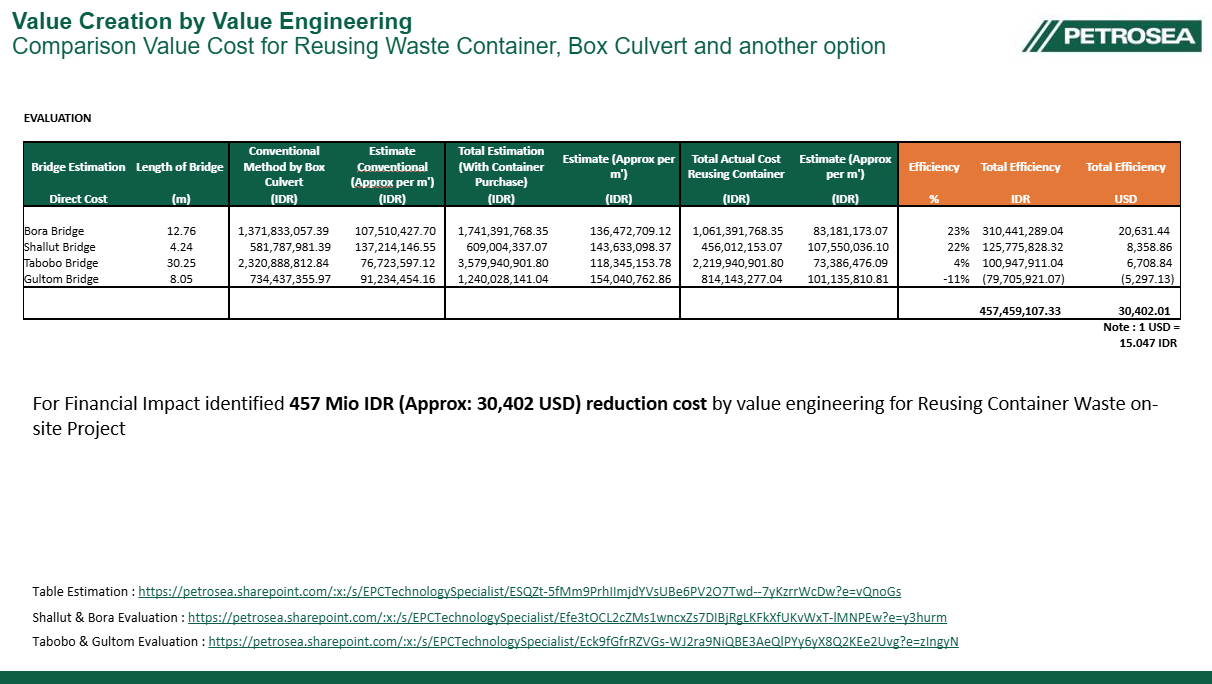

4th Winner, Petrosea Innovation Day 2023—26% cost reduction (~$111,606), 21-day acceleration, 70 tons steel reused.
Pioneered converting obsolete shipping containers into structural bridge assets, bridging fast-track execution and circular-economy sustainability.












Cut budgets 26% and accelerated execution 21 days.
Reused 20 containers (70 tons steel) supporting 60-ton loads (SDG 12).
Shifted evaluation to a triple-bottom-line (Profit, People, Planet).
Analyzed constraints and waste challenges for a value engineering process.
Structural redesigns for four NHM bridges (Tabobo, Gultom, Shallut, Bora).
Documented calculations into design guidelines.
